I start with an overview of the site from their entrance gate to the ramp down into the "big hole." Note that they are already removing forms from the north wall that we saw them pour yesterday.
1:54:54 They are finally using the crane that you could see parked in previous postings! Be warned, this is going to be a long post because this is the first time I've seen a precast concrete column set. I caught them handling the first column off the truck for this site. Unfortunately, the crew kinda acted as though it was the first time they have seen a column being set. I would have thought the crew would have done this type of work at other sites. Note the truck that is down in the "big hole" that has two columns. And the crane has the hook by a column ready for the riggers to do their thing.
I missed the pouring of the footing for the wall in the southeast corner of the "big hole." There was another "sidewalk superintendent" with me today, and he explained that he learned that the orange caps on the rebar is not needed for iron workers, but they are needed for concrete workers.

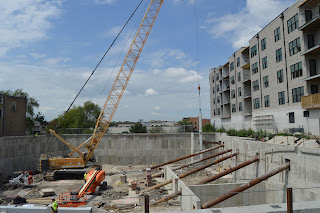

My first shot of the crawler crane with the house turned. We will be seeing a lot more of this crane in subsequent posts as they set beams and slabs. I never did catch another time when they were setting columns because there are very few columns in the building compared to slabs.

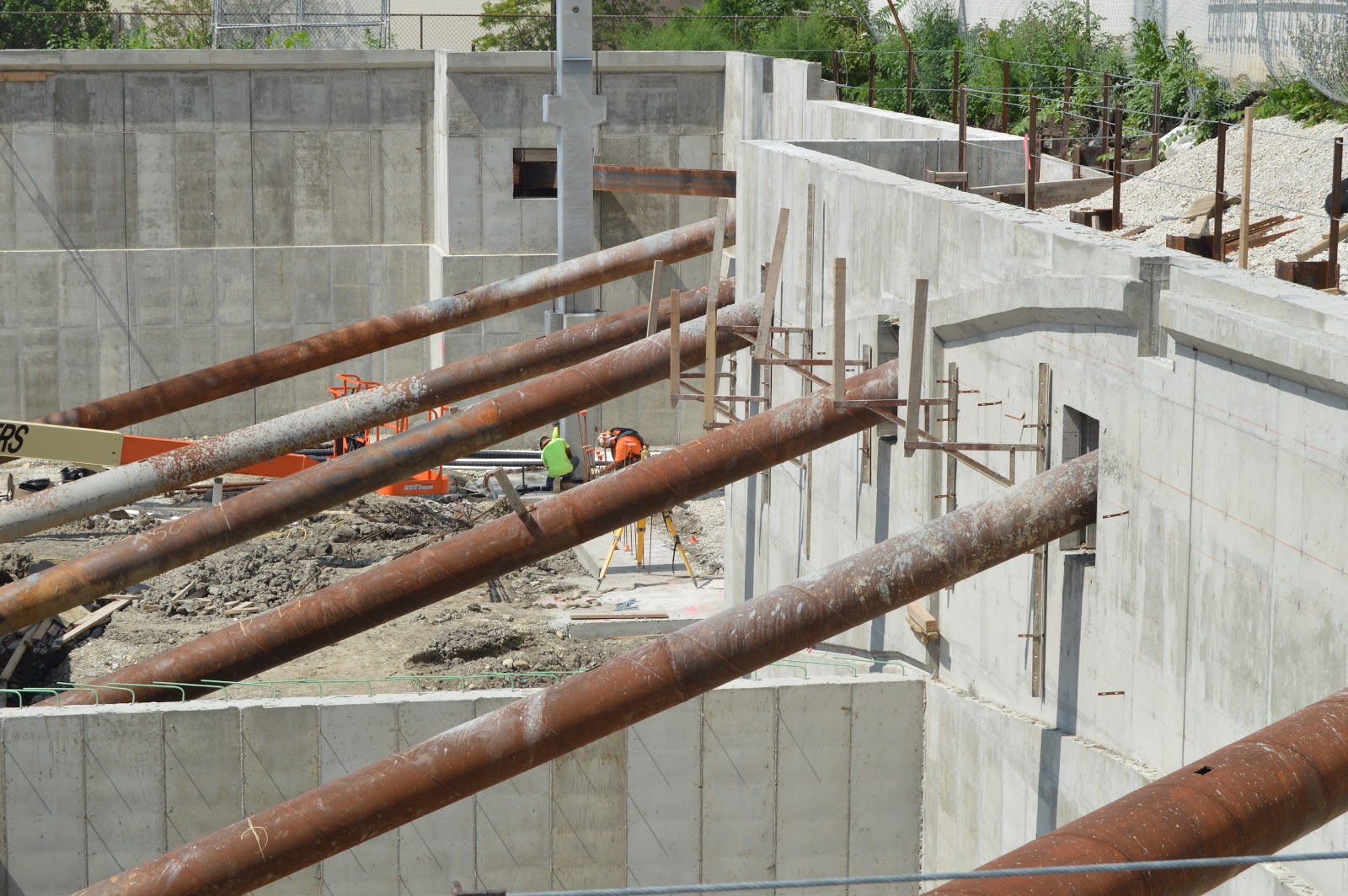

2:02:42 Note the surveyor instrument to the left of the two guys talking about what they should do.
2:04:24 It looks like I'm so excited in anticipation that the crane will lift something that I got my finger in front of the lens on the upper left. I've taken 10s of thousands of photos with this camera and this is my first, and hopefully last, "finger picture." The wire on the upper right is a reminder that I'm taking all of the pictures from this side of the site through the chain-link fence that surrounds their property. The people over on the ramp are concrete workers taking down the forms from yesterday's pour and getting ready to form up a wall on the new footing we just saw. The right "talker" is on a cell phone.
2:11:58 Finally, the guy on the cell phone starts walking over to the corner of the building.
2:17:48 As a rigger drives his lift to the right, the hook is being swung to the other end of the column. And we can see the concrete workers at the end of the wall.
2:18:34 We have lift off.
2:18:48 Finnlly, time resolution to the seconds is beginning to make sense.
2:19:04 After watching this crane operator for a couple of months, he struck me as being good. Think about how he is having to turn the crane and move the boom angle as he raises one end of the column so that the other end remains at the same spot on the truck and doesn't slide. (As the crane turns, the radius between the crane and the column's bottom changes. So he moves the boom to change the radius.)
2:19:26 A rigger is at the base of the column. I guess he is there in case the hook is not exactly over the bottom. In that case, the base would swing when lifted off the truck, and I presume the rigger would try to dampen the swing.
2:19:42 But the operator nailed it, and it came straight up off the truck.
2:19:54 I took a sequence of photos to get time stamps.
2:20:08
2:20:22
2:21:00
I realized that this is the first chance I have had to see the side of the crane, so I take a closeup view hoping to find the model number. (Later, we will see the model number when we see the rear of the crane. Stay tuned.)
2:25:26 Note the lift has been parked for now and there are four workers over in the corner near where the column is to be placed.
2:26:10 The riggers don't start dealing with the details of the placement site until after the column is hanging over their head.
2:26:48 In fact the column is lifted back up because it seems there is quite a bit of prep work that needs to be done for the base. I think they were putting the bolts in the concrete pad that will hold the column. Why they couldn't have done this before the column was lifted, or even before the truck with the columns arrived is an issue that I could not figure out. I had seen surveyors over their earlier making marks on the pad.
2:33:34 There are at least five workers in this view. Two are working on the concrete pad. Two are talking to each other and probably looking at blue prints. One seems to be just standing.
2:38:42 The column is being lifted, moved back, and lowered to the ground while the man-lift is maneuvered next to the column.
2:39:10
2:39:34
2:40:22 Because a hole needs to be drilled in the column. What I didn't record was that they had to wait while someone walked to the tool truck to get the drill, and then they had to wait while someone strung extension cords across the entire diagonal of the "big hole" so that that drill would work.
2:41:14 It takes a while to drill a hole into cured concrete.
2:44:02 Now they have moved the column back into its proper position.
2:44:32 It has to be tricky getting all four holes in the column alighned with the four bolts that have been put into the concrete pad.
2:46:38 The worker in the orange vest is holding a pry bar. I'll learn that pry bars are a rigger's best friend. In fact, it looks like there may be one by the left, back corner of the column being used to nudge the column base to the southeast.
2:49:12 Remember that hole that got drilled. The rigger on the lift is now inserting a bracket that holds a metal bar.
2:56:50 The bottom of the metal bar is attached to the ground to form a diagonal brace for the column.
3:00:50 The lift is going up to the top of the column...
3:01:22 ...to unhook the crane cable.
3:01:42 A ladder could have been used to drill the hole. But working at the top of the column justifies the use of a lift.
3:01:50 A photo to timestamp how quickly the boom of the lift can be telescoped in. And because I'm bored and digital photos are cheap.
3:03:28 Swinging back to get the second column.
3:02:56 Hooking on.
3:03:46 Standing clear.
3:04:08 Tilting up.
3:04:16 Close to vertical.
3:04:38 Ready for liftoff. (Thanks to our space program, liftoff is now a one word noun.)
3:06:46 I still don't understand why they can't prepare the base until after the column is hanging over them.
3:07:44 The trailer of the delivery truck is now empty, so he is headed back to the Mid-States Concrete plant in South Beloit, IL. (One advantage of being so far behind on my uploading is that I learned about the name of the supplier much later.)
3:09:12 I went back and looked at some of the previous photos. They are just now inserting those bolts into the slab? That job could not have already been done earlier today when they found themselves standing around waiting for something to happen.
3:14:12 The column goes back up.
3:14:24 Not sure what they are doing. I took a lot of pictures because I couldn't figure out what was happening.
3:16:56 Column has gone back down, maybe a little to the left of where it was.
3:17:06 It is on the ground just left of the bolts they installed. Are they going to work on the side of this one?
3:17:32 Its moved a little further to the left. It looks like the guy on the left is drinking out of a bottle. In otherwords, not much is happening. Note their normal quitting time is 3pm, so they are probably getting paid overtime to stand and look at the column.
3:20:06 The column goes back up.
3:20:38 The boom of the man-lift has been moved from the far side of a wall brace to this side of the brace so that it can be used on the column. So when it was orange vest's turn to do something, he first had to take a drink of water so that he could hold up everybody else even longer?
3:26:14 Given the time lapse, I evidently didn't take a photo of the actual drilling of the hole in the side because in this photo they are moving the column back to the right...
3:27:10 ...over the bolts that have been placed in the concrete pad.
3:27:26 As with drawbridges going down, the last couple of inches take the most time.
3:27:34 Putting nuts on the bolts.
3:28:56 Two pry bars in action.
3:29:02 Just the north pry bar still working.
3:31:28 The east diagonal brace is being fastened on the ground while another brace is being carried...
3:31:56 ...to the south side...
3:32:16 ...so that it can be fastened to the side of the column.
3:33:16 I was so relieved that they were nearing the end of working on this column that I didn't even bother taking a picture of them fastening the south brace to the ground. So each column has two diagonal braces at 90-degrees to each other.
3:35:52 I had learned that I could walk behind the remaining buildings north of the site to get a view from the other side of the north wall. Notice that it took me over two minutes to walk from the south side of the site to here, but the cable has still not been released from the column.
3:36:06 The above view is looking east from the public access spot. This view is looking south from the same spot along the backside of the existing buildings.
3:36:56 I was so frustrated with how long it took to place that column because only one job was done at a time that I did not wait around to get a photo to time stamp when the cable was removed from the column. The workers did not do tasks in parallel. They took turns watching each other work even if there was no dependency between their tasks. I've worked enough with Pert Charts to know that serializing all of the tasks is optimally bad.
This photo shows an intermodal train is going through town.
